Freja

The management, design, development, launch and early operations of the Freja satellite

Sven Grahn

FREJA is a Swedish/German satellite designed for research into the aurora. The satellite was launched "piggyback" on a Long March 2C (CZ-2C) rocket from the Jiuquan Satellite Launch Center (41° N, 100° E) in China on 6 October 1992 and weighed 256 kg at launch. The orbit ranged between 600 and 1720 km altitude at an inclination of 63°. FREJA is a sun­ pointing spinner (10 rpm) with a 2.2 m diameter.

The Swedish Space Corporation was the Prime Contractor on behalf of the Swedish National Space Agency.  Project Scientists were Prof Rickard Lundin at the Swedish Institute of Space Physics in Kiruna and Prof Gerhard Haerendel, Institut für extraterrestrische Physik, Max Planck­ Institut, Garching.

The Mission

FREJA made high-resolution measure­ments in the upper ionosphere and lower magnetosphere in the tradition of Sweden's first satellite, VIKING, launched in 1986. The high resolution was made possible by an S­-band downlink with a maximum experiment data rate of 501.4 kbps. The scientific payload composition  is shown  in the  table below. Data was received at Esrange, Kiruna, Sweden and at the Prince Albert Satellite Station in Canada's Saskatchewan province. Prince Albert was well located to receive real­ time data when the satellite traversed the auroral oval. Commands were only be transmitted from Esrange. FREJA had a stored-command capability in order to operate over Canada without a real-time command link.

FREJA Experiment Summary

Nr  Experiment Name Principal Investigator  Mass (kg) Power (W) Data rate (kbps)
F1 Electric Fields Royal Inst. of Technology, Sweden 5.37 9.0 30.7
F2  Magnetic Fields APL/Johns Hopkins Univ., USA 3.97 4.0 14.33
F3C Cold Plasma NRC, Canada 5.79 6.2 16.38
F3H  Particles; Hot Plasma Swedish Institute of Space Physics, Kiruna 9.52 15.6 42.98
F4 Waves Swedish Institute of Space Physics, Uppsala 8.40 11.6 42.98
F5  Auroral Imager Univ. of Calgary, Canada 9.94 6.7 44.01
F6  Electron Beam Max-Planck Inst., Garching, Germany

-

- -
F7 Particle Correlator Max-Planck Inst., Garching, Germany 8.49 13.0 26.61
6 wire booms (l<15m) and 2 stiff (l= 2m)

21.60

-

-
Housekeeping

-

-

5.13
Synchronization

-

-

6.15
TOTAL

73.08

66.1

261.98


Budgets, partners and schedule

FREJA had a total budget of less than 160 MSEK including satellite, experiments, launch and operations. This low cost was partly due to the use of a piggyback launch opportunity, but also to the streamlined project organization and competitive procurement. The project was initiated when the CZ-2C launch reservation was "left over" from the cancelled Mailstar project, a store-and-forward low-orbit communications satellite. The launch reservation was the result of a competition for launching Mailstar, and not particularly adapted to an auroral mission. However, the inclination  provided  by the CZ-2C (63°) was high enough to stimulate the interest of Swedish scientists into using it for an auroral research mission. The launch price was very attractive, making it feasible to build a satellite despite the acute lack of funds in the Swedish space budget. The funds available were less than half the cost of the low-cost VIKING project (VIKING satellite [excl experiments] and launch: 238 MSEK in 1991 price level). The Swedish National Space Agency and scientists showed great trust in SSC and let the company use unconventional methods to cut costs.

The table below summarizes the design and development costs of the FREJA satellite (excL experiments) plus the launch cost in current prices. In this calculation the dollar has been assumed to be worth 6.60 Swedish Crowns.The financing of these costs came from

Also, it should be noted that experiment development costs are not included above, but they were covered by the Space Agencies of the respective country of origin of the Principal Investigators (PI). It is difficult to estimate experiment development costs, but an educated guess is that they could amount  to maybe  50%  of  satellite  development  and launch costs.

In 1992 operations planning and actual spacecraft operations for 18 months was estimated to cost about 12 MSEK. Thus, total project costs including everything was the estimated to be on the order of 160 MSEK.


The Prince Albert Satellite Station, one of Canada's contri-
butions to the project. In the picture:SSC's Bengt Holmqvist
at a visit in February 1992.

The schedule  of  the  project  has  been determined by the time needed to design the experiments.  The launch  was delayed  from 1991 to 1992 to  allow enough  time for experiment development. One must  remember that these instruments were  really "at  the  cutting edge of technology" and in many respects much more sophisticated than satellite subsystems. The bar-chart below summarizes the project schedule.

Launch vehicle

The Long March 2C (CZ-2C), is a two-stage liquid fuel rocket manufactured by what was the called the Beijing Wan Yuan Industry Corporation under the Ministry of Aerospace Industry. The lift-off mass was about 191 tons and the lift-off thrust is 2747 kN. The rocket was 34 meters long and had a diameter of 3.35 meters. Both stages are propelled by N204 and UDMH - Unsymmetrical DiMethyl Hydrazine, H2NN(CH3)2.

The launch arrangement

For launching FREJA the CZ-2C was modified by the addition of a cylindrical transition bay (or "piggyback cabin") between the Chinese FSW-1 satellite and the top of the second stage of the CZ-2C. The transition bay was split into two cylindrical sections. The FREJA satellite had an interface ring which was clamped between the outer rims of these two cylinders.

Upon reaching orbit the main satellite (FSW-1) was separated by firing four explosive bolts at the interface between the transition bay and the FSW-1. At  the same time retrorockets at the rear end of the  CZ-2C second stage fired and ensured a smooth separation of the main satellite.

Flight sequence

The table below shows the nominal sequence of flight events up to FREJA separation.  The picture on the right shows the cylindrical transition bay (or "piggyback cabin") between the Chinese FSW-1 satellite and the second stage. The mechanical  interface  between  the  CZ-2C and the satellite is  provided  by an  aluminium ring which is clamped betwen the two halves of "piggyback cabin".  The  main satellite is released first while the CZ-2C stage is under 3-axis control.

After a reorientation maneuver  to  put the separation vector parallell to the orbital tangent  at  the orbital apexes, the top half of the "piggyback cabin" was separated by firing four explosive bolts. These bolts only acted on this part and FREJA gently moves away from the CZ-2C stage which is braked by small solid rockets. At separation the angular rates of the second stage were  very low ( <0.35°/sec).

A few seconds after separation solid propellant spin rockets are fired to give FREJA a 50 rpm spin in preparation for ignition of orbit adjust motors. The CZ-2C puts FREJA into a 203-317 km parking orbit at  63° inclination.  This  orbit must be raised to reach scientifically interesting regions and to keep the satellite from decaying.

The  Thiokol STAR 13 A rocket motor fired at the southern apex of the parking orbit to give FREJA an apogee of about 1700 km. As this apogee was reached approximately 50 minutes later the STAR 6B motor fired to raise perigee to 600 km, high enough to avoid rapid decay of the satellite.

The launch site

The  launch site for the FREJA satellite was the Jiuquan Satellite Launch Center in the Gansu province of the People's Republic of China at approximately 41.3°N 100.3°E. It is operated by what was then called the CLTC, "China Satellite Launch and Tracking Control General", an organization under soemthing then called the Committee of Science, Techno logy and Industry for National Defense (COSTIND). The center is linked by rail and road  to the nearest  airport  (Airport  #14) 94 km south of the launch site. The video below shows how Freja arrived at the aiport of the launch site.





The launch site at that time consisted of a Base Area with a residential area, shopping center, bank, post office, movie theatre, TV station, hotel facilities, schools, power station and the range control center. This base area is called Dong Feng, "The East Wind".

The Technical Center for the CZ-2C rocket and its payload is roughly 20 km north of Dong Feng and this is the place where the launch vehicle is assembled and checked out horizontally. FREJA was checked out in a separate building (BM) near the launch vehicle integration building. FREJA pyrotechnics and rocket motors were stored in a room in the BM building.


SSC project team members on site at the launch site was taken in the BM building
on the 25 September 1992. Left to right: Göran Bergman, Sven Grahn, Anna Laurin,
Peter Rathsman, Bengt Holmqvist, Gudmund Johansson.


A crew training version of a CZ-2C launch vehicle at the
Technical Center. Sven Grahn, SSC, on the left, Stig
Alterbäck, FFV, on the right.

The Launch Pad used in 1992 for CZ-2C launches is situated another 30 km north of the Technical Center. The launch vehicle and satellites are transferred by road to the launch pad.

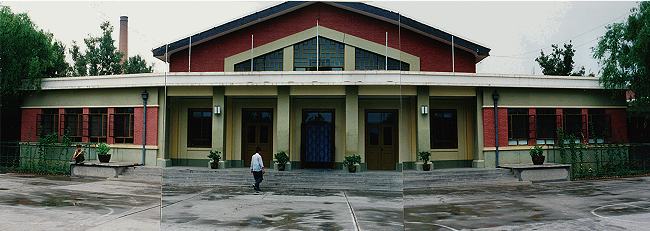

The hotel where the Freja team stayed.

Orbit insertion timeline

For a lift-off mass of about 259 kg the pre-launch timeline below was calculated. The timer function of the FREJA System Unit fired rocket motors, deployed antennas and started transmitters at the times indicated below. After the fourth Esrange contact the transmitter in the satellite was operated by ground commands, direct or stored, instead of the pre-programmed events in the on-board computer memory.

Event

Hr:min.sec
from lift-off

Lift-off

0.00

Injection into 203-317 km orbit (Position:18.44 N,115.28°E)

9.38

Spin up of FREJA to 50 rpm by solid spin rockets.

9.48

Maneuver 1 at rev 1 apogee puts FREJA in 285-1723 km transfer orbit. Sat. posi­tion:63°S, 156°W.Delta-V=386.4  m/s

36.36

Maneuver 2 at  transfer orbit  apogee  puts FREJA in final 599-1725 km orbit with a 108.6 minute period. Sat. position: 62°N, 9°E Delta-V=84.1 m/s

01:29.24

Spin down of FREJA to 11 rpm by solid spin rockets.

01:31.24

Start Low-Speed Link transmitter. Receive at JSLC.

01:32.09

Stop Low-Speed Link trans­mitter

01:55.00

Deploy S-band antennas

02:26.00

First Esrange Contact start

03:11.24

First Esrange Contact end

03:34.24

Second Esrange Contact start.

05:03.54

Second Esrange Contact end

05:23.48

Third Esrange Contact start

06:56.30

Third Esrange Contact end. Last Esrange pass Day 1.

07:10.54

Fourth Esrange Contact start

17:36.36

Fourth Esrange Contact end.

17:43.18

The map below show where the satellite was from launch up to and including the moment when the Low Speed Link was first turned off. The radio horizon around JSLC is shown.


Satellite design

Overall configuration

A block diagram of the satellite is shown below.

The structure consists of a central tube machined from cast magnesium. Inside this the solid rocket motors are mounted on a Kevlar adapter to limit heat soak into the satellite from the spent motors. The pictures and sketch below illustrate the stucture concept. In the photograph the launch vehicle interface ring is not mounted.


Four radial walls connect the central tube with the CZ-2C interface ring and on the top and bottom of  the walls the top and  bottom platform decks are mounted. Platform and science equipment are mounted on the walls and the platforms.

The unusual mechanical interface to the launch vehicle and the need to locate wire boom assemblies and scientific instruments on the largest possible radial distance from the spin axis made it impossible to  locate solar panels on the outside  perimeter of the satellite.

The top surface was used to locate the solar panels and a sun-pointing attitude gives maximum electrical power (130 W End-Of-­Life) and acceptable, albeit not optimum, viewing angles for the scientific sensors. This mounting of the solar panels leaves the back of the  panels free so that heat can be radiated.

Spin-stabilization was needed to  keep the so­ called wire booms for measuring electric fields extended. Also, it is suitable for a satellite making a two-impulse Hohmann transfer. The two rocket motors can be placed along the spin axis with nozzles pointing in opposite directions.  The  spin vector  attitude was controlled by the well-proven quarter-orbit magnetic torquing method. This was used for FREJA to make the spin axis track the sun. A three-axes magnetometer, redundant solar aspect sensors and an IR earth sensor were used for  attitude determination.

Redundancy was used whenever possible. FREJA has redundant transmitters, receivers, batteries, solar array shunts, telemetry systems, telecommand  decoders, computers, pyro circuits and attitude sensors and actuators.

Structure

The Central Tube made by the Weda foundry, Sweden connects the vertical aluminium honeycomb walls. It also provided a mounting interface for the mounting of the STAR 13A and STAR 6B motors as well as handling points for the Mechanical Ground Support Equipment (MGSE). The central tube is made of cast magnesium and has an overall thickness of 5 mm. The length and outer diameter are 440 mm and 412 mm respectively.

Aluminum Honeycomb Panels made by Hexcel, Belgium are used as the structural  members  of the  satellite  on  which  other  equipment  units are mounted. They consist of Al/Al honeycomb core  sandwiched  between  thin  aluminium sheets glued to  the  core. The core is manufactured by Hexcel and is corrosion­ resistant  and perforated. Commercial aircraft grade honeycomb has been used to  reduce price. Dimensional  tolerance for this grade was stated to be 0.2 mm/100 mm but was found to be about 2-4 times better. A thicker adhesive is required than for "space-­ grade" honeycomb panels, which adds about 300 grammes/m2 compared to a standard space adhesive  (Redux 312L).The total mass penalty for FREJA was not more than 800 grammes, while material costs were reduced by a factor of 10. With the exception of the radial walls (see section "Satellite Configuration") which required integrated edge-beams, all panels were cut out of large standard platforms.

Structural inserts interconnecting honeycomb panels were bonded when the panels were in place, assuring a stress-free structure in spite of dimensional mismatches on the order of 0.5 mm due to panel non-planeness.Potted equipment inserts were not mounted flush with the panel, but were manufactured with a flange of initially 1mm thickness.  Each set of inserts corresponding  to  one box attachment  were  then  milled  flat in one operation. The milling operation,  while non-trivial, could be performed in a well-equipped machine-shop  and  was not  particularly costly.The insert flange was bonded on the lower side to the panel facesheet, resulting in a torque capability exceeding that of the screw, although the weight of the insert was comparable to a standard Shur-Lock insert.

A new procedure for  potting inserts with Stycast 1090 was developed, ensuring a minimum void (approximately 1% as opposed to typically 30% in the Tele-X project). The main feature of the potting procedure was potting the inserts upside down and using multiple filling operations, allowing the potting compound to settle in between each operation.

The Rocket Motor Support is manufactured by ACR AB, Sweden. The STAR 13A and STAR 6B rocket motors were mounted inside the central  tube.  In order to insulate them thermally from the rest of the satellite the structural detail connecting the motors to the central tube had to be manufactured  from a plastic material. Therefore the rocket motor support material is Kevlar 49 fibre as a reinforcement to the Eccobond 104 epoxy.

Thermal control

Multi-Layer Insulation material for thermal control is manufactured by the Sheldahl Company, U.S.A The temperature of the satellite was controlled by applying appropriate covers of paint or. insulating blankets. The insulating blankets consist of multiple layers of metallized plastic foil with a plastic net spacer between each layer. The type of foil and its coating varied depending on where on the satellite the blanket shall be mounted. Therefore three different types of foils had to be used on FREJA.

Propulsion system

Rocket Motor no.1, is a STAR 13 A manufactured by Thiokol. This rocket motor is used to raise the  orbit  of  the  FREJA satellite. The reason for this is that the Chinese launch vehicle delivered  the  satellite  in  an  orbit  which was  too  low for making any scientific investigations. The STAR 13 A fired under pre- programmed control from the FREJA System Unit and raised the apogee (high point) of the orbit from approximately 300 to 1700 km. (See picture on the right).

Rocket Motor no.2 , is a STAR 6 B manufactured by Thiokol. The STAR 6B fired  under  control from the FREJA System Unit and raised  the perigee (low point)  of  the  orbit from approximately 200 to 600 km.

Spin Rockets were manufactured by the Beijing Institute of Space Machine and Electricity under the Chinese Academy of Space Technology. Two of these small (Propellant mass: 370 grammes, Total impulse: 750 Ns) solid-propellant rocket motors were used to spin up the satellite after separation from the Long March 2C rockeL Two other of these motors were used to reduce the spin rate after firing of the  two Rocket Motors. The ignition of the spin rockets was controlled by an onboard timer function in the FREJA System Unit.

Power system

The basic design concept for the power system was developed by Dr Friedhelm Melzner of the Max-Planck Institut in Garching based on experience from a similar system on the AMPTE/IRM satellite. This simple design uses Zener shunt voltage regulator at each of the eight solar panels (130 W EOL). Thus, in sunlight the bus voltage is determined by the solar panels. Separate strings of solar cells on the  panels provide enough voltage to charge the Ni-Cd batteries in sunlight. The voltage of the solar panel shunts is slightly  higher  than that of the voltage regulators connecting the batteries to the  main bus via diodes. Therefore, in sunlight the batteries are disconnected from the bus.

The Solar Array was manufactured by Telefunken SystemTechnik, Germany and  provides electrical power to the satellite for operating all onboard subsystems and for charging the Ni-Cd battery. The cell type used is BSFR (Back Surface Field and Reflector) with a size of 19 x 39 mm and a thickness of 250 µm. This cell type has an efficiency of 14% at 25°C, one solar constant and Air Mass Zero. Each cell is covered by a conductively coated cover glass. This is required for scientific reasons since the satellite's electric potential has to be as close to that of the surrounding space plasma as possible. The cover glass material is Cerium-doped microsheets (CMX) with a 300 µm thickness and coated with ITO (Indium-Tin-Oxide). The  whole solar array consists of 8  panels each having 200 cells. Thus, entire array has 1600 cells and generates 168 Watts maximum. The cells are mounted on an aluminium honeycomb substrate with a 15.6 mm thickness covered with a 50 micron thick KAPTON H foil. One of the eight panels is shown below.

The Nickel-Cadmium Batteries were designed and manufactured  by  the  Shanghai  Institute  of Space  Power  Sources,  China.  Two  such batteries are installed in  the  satellite, one being an "in-orbit  spare". Each  battery contains  24 cells, has a rated capacity of 6 Ah and weighs 8 kg.

The Lithium Battery was manufactured by ElektronikCentralen, Denmark and provided power to the satellite during the initial phase of the mission immediately following separation from the launch vehicle. During this period the solar array was not fully illuminated by the sun and the satellite needs to  be turned. Power to this turn with the magnetic torquers is drawn from the Ni-Cd batteries,  but  these needed to be augmented during the first two days in orbit by an expendable  primary battery  - i.e. the Li-battery.

Radio system

Simulations of the orbit determination problem for FREJA showed that it was sufficient to use angular tracking with the 9 meter S-band receive antennas that SSC has at ESRANGE at that time. Thus, no ranging is needed and therefore no transponder.  Separate transmitters  and receivers could be used. Such units are much less costly than a full transponder. Redundant 2 Watt S-band PM transmitters were used.

Very simple, reliable and rugged FM receivers were used. These redundant units are similar in design to the range safety receivers used on launch vehicles. They operated in the 450 MHz Earth-to-Space band allocated by the ITU. At  this frequency the  Doppler shift is low, and the signal spectrum is quite narrow. Therefore a simple FM receiver without PLL tracking of the uplink could be used. The signal on the uplink was a simple bi-phase-L PCM­ signals at 1200 bps.

S-band transmit antennas were manufactured by what was then Ericsson Radar Electronics, Sweden (nowadays RUAG Space). One of these antennas was mounted on each side of the satellite (sunlit and dark side) . These conical helix antennas were used to transmit the data from the satellite "platform" and the scientific instruments to the ground stations.

450 MHz command reception antennas were manufactured by FFV Aerotech, Sweden. One of these turnstile antennas was mounted on each side of the satellite (sunlit and dark side).

S-band transmitters (T-102SE) were manufactured by what was then Aydin Vector, U.S.A (nowadays L3). The satellite carries two of these units. One of these was an "in-orbit spare". They both operated at 2208.1629 MHz with 2 Watts nominal output power.

Command receivers (RCC 500) were manufactured by Aydin Vector, U.S.A. The satellite carried two units to receive commands from the ground. One receiver was an "in-orbit spare".  They  both  operated on 449.95 MHz.

The high speed data link from FREJA operated on 2208.1629 MHz at 2 Watts RF output power. The 262 kbps data stream was phase-modulated on to the carrier . A doubling of the data rate to 524 kbps was also provided.

A low speed data link on 400.55 MHz (2 Watts RF power) which sent AFSK signals at 1200 bauds was intended to send housekeeping signals to receivers on the ground equipped with omnidirectional antennas. By using a simple AFSK decoder and a personal computer the state of onboard equipment could be checked. The onboard  antenna  for this link was a whip antenna for cellular phones used on cars. This linked worked, but the fading of the signal due to the rotation of the satellite limited the usefulness of the system.

Attitude control

Spin-stabilization was used to keep the so-called wire booms for measuring electric fields extended. Also, it is suitable for a satellite making a two- impulse Hohmann transfer. The two rocket motors can be placed along the spin axis with nozzles pointing in opposite directions. Since the CZ-2C did not provide any spin the satellite had to spin up from zero spin rate as soon as possible after separation. This was done within 10 seconds after separation so the depointing caused by residual rates did not affect the final orbital parameters very much.

The well-proven quarter-orbit magnetic torquing attitude control method was used to make the spin axis track the sun. However, a low orbit gives a good magnetic control authority, but it also causes strong gravity­ gradient disturbance torques for a satellite with long wire booms. These torques caused spin axis movements of the same order of magnitude as the motion of the sun in inertial coordinates.

The Primary Sun Sensor was designed and manufactured by Science Management and Engineering GmbH,  Germany (see picture below).  This  unit measured the orientation  of  the  satellite's  spin axis relative to  the  direction  of  the sun  during the  collection  of  scientific  data. The key sensing element is a Linear CCD Image Sensor (TH  7805A(Z))  manufactured by Thomson CSF, France.

The Secondary Sunsensor was designed and manufactured by ACR AB, Sweden. This unit measured the orientation of the satellite's  spin axis relative to the direction of the sun during the initial phase of  the mission  (2  days) when the sun was not aligned with the spin  axis,  but instead  >90  degrees  from  the  spin  axis.  The key sensing element was a  Position Sensitive Photo  Detector Type 2L4 from SiTek.

Magnetic Torque Rods (D42653,032660) were manufactured by ITHACO Inc., U.S.A These units are electromagnets used to change the orientation of the spin axis and the spin rate of the satellite.

When current is applied to the Precession Torquer it interacts with the Earth's magnetic field and generates a torque which turns the satellite. When current is applied to the Spin Torquer it interacts with the Earth's magnetic field and generates a torque which changes the spin of the satellite. The current has to be applied with different polarity as the satellite spins. In fact the Spin Torquer can be seen as the rotor in a DC electric motor where the Earth's magnetic field is the stator field. Commutation of the current was provided by the magnetometer.

The Magnetometer (SAM-72C-HR) was manufactured by the Schonstedt Instrument Co., U.S.A and measured the three components of the Earth's magnetic field and this data was transmitted to the ground where they were used to determine the orientation of the satellite. Also, the magnetic field component perpendicular to the spin axis was used by the FREJA System Unit to determine when to change the polarity of the current in the spin rate-control.

The Nutation Damper was designed and manufactured by the Max-Planck-Institut in Garching, Germany. This unit consisted of a closed aluminium tube filled with a viscous fluid (Fluorinert FC-43 made by 3M). The viscous damping characteristics of the fluid reduced any irregularities in the spinning motion of the satellite. One of two nutation dampers is shown at the red arrow below.

The System Unit

Normally units that provide "platform functions" are procured from different sources and their interconnection is covered by elaborate internal interface specifications. For FREJA a scheme was adopted that was used on AMPTE/IRM and other satellites, i.e. to have a common unit performing most "platform functions". Outside this unit are only batteries, solar panels, attitude sensors, attitude actuators and propulsion  units. In FREJA this unit was called the FREJA System Unit (FSU). The picture below shows the FSU with radio units mounted on its side.

It is a 13 litre box weighing approximately 15 kg containing 13 printed circuit  boards (220x260 mm). It  performs  the following functions:

The FSU, developed by the Swedish Space Corporation, was fully redundant and used MIL 883 B-level components.  The onboard processor was Matra-Harris' 80C31.

Combining these all these functions in one unit saved interface engineering costs. One person handled the interface work as an integral part of the design process. Of course this advantage was partly offset by more complex testing of these functions.

The FSU communicated with experiments through a single connector only carrying a two­ way serial link via opto-couplers and 28 VDC for powering the experiment and a heater power circuit. All telemetry data going to the ground were also available to all experiments and commands are sent to the experiments only as part of this serial bitstream. No high­ level commands (relay closures) except pyro firings were provided by the FSU.

This very clean interface to each experiment was be simulated by an extension board to a personal computer - a "satellite emulator" against which each experiment could be designed and tested. When the experiments arrived for integration on the satellite the data handling interface rarely presented problems.

Experiment support units

The Wire Booms (Type 84100) were made by Weitzmann Consulting Inc, U.S.A  and supported  the F1  (Electric  Fields) and F4 (Waves) experiments. Wire boom systems contain a reel of cable connected  to  a  spherical electric field sensor. The wire boom systems reeled out the cables to 15 meters length when the satellite had reached its final orbit the spin of the satellite kept the wire taut. The wire was actually a multiconductor cable which transferred signals from the spherical tip sensor to the electronics units of the F1 and F4 experiments. Thus, each of the six Wire Boom systems consisted basically of a cable reel, a DC electric motor, the cable, various switches and connectors and structural details.

The Stiff Booms were designed and manufactured by Science Management and Engineering GmbH, Germany. There are two stiff booms on  FREJA, each 1.9 metres long. Their purpose was to extend the flux gate (F2 instrument) and search coil (F4 instrument) magnetometers from the satellite body. Two other sensor probes were also attached to the booms, namely the so-called Langmuir and high-frequency probes (F4 instrument).  The two booms each have two hinged sections. Each boom section consists of a combination of glass fibre and CFRP (Carbon-Fibre Reinforced Plastic).


One stiff boom system delivered to FFV Aerotech in Arboga.


Deployment test on a rotating table in München. Wooden frame is a gravity compensation system.

EEE Parts Selection

A decision was made early in the project not to buy "space-qualified" components for the "System Unit" because of their intolerably long delivery times. A different component specification also saved costs. Thus, MIL-STD parts were bought having a radiation tolerance several times higher than the 2.6 kRad total radiation dose expected during the mission and also reasonably  insensitive to  Single Events. Critical components (CPU, RAM,..) were bought to higher specifications. Receiving inspection and test (parameter testing) was used on all electronic components. Below follows a list of EEE-parts in terms of manufacturer, types and specification.

Procurement methods

Competition

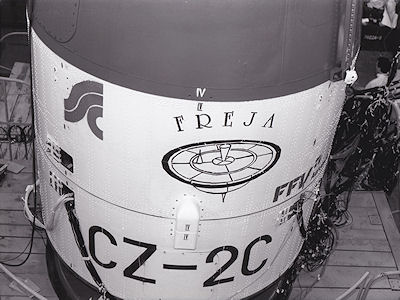

The CZ-2C and Freja ready for launch. No connection with text on the left :-)

Wherever possible, competition was used in procuring equipment and services. During phase B competing proposals were submitted for all hardware and manpower tasks. In the development phase suppliers were chosen from these bidders, except when a country participating in the project contributed in kind with hardware or services. A list of suppliers is found in the table following this section.

Elimination of subsystem contractors
Swedish Space Corporation as the Prime Contractor for FREJA assumed subsystem responsibility and only procured on equipment level. Since many units were off-the-shelf equipment and because the "System Unit" combined several subsystems such an approach is possible for a very small project team (9 persons). It will save money by avoiding the costly layers of management that subsystem contractors would introduce. Not only is a layer of management avoided but also a layer of documentation.

Limited subcontractor responsibility
A subcontractor, FFV Aerotech, carried out the  practical work of assembling the satellite, transporting it to the test sites and carrying out the tests as specified by SSC. The "Assembly, Integration & Test" (AIT) contractor had a work force consisting of 6 persons. The AIT contractor was given practical tasks and was not required to take any significant technical risks. This made it possible to keep the AIT contract sum low and also to obtain a fixed price contrac. SSC absorbed the technical risk.

Another potential advantage of limiting supplier technical responsibility and financial risk is that smaller companies can be used. Such smaller suppliers may be very skillful, unbureaucratic, have small overhead costs and offer quick tum-around times, while not being able to absorb so much risk.

Fixed price contracts
All equipment contracts and most service contracts were fixed price contracts. U.S. companies offered firm, fixed contracts, while European suppliers insisted on escalation clauses!

Minimize documentation requirements
Suppliers of off-the-she lf equipment were encouraged to  propose minimum documentation while adhering strictly to their normal quality and test procedures. Preparing documents is very costly, and by asking the supplier to use the methods of QA and test employed in delivering equipment to ESA, NASA or DoD, the project essentially "piggybacked" on the QA requirements of these organizations.

Costly equipment acceptance tests performed "in-house"
In addition, SSC made additional savings by performing certain equipment acceptance tests in-house. It was, for example, found very expensive to let the vendors perform thermal vacuum testing of the hardware. The price was typically USD 10,000 per unit. These tests were performed in-house by SSC on many units: Rx, Tx, Sun sensors, shunts etc..

Although this could have put SSC in a difficult contractual position had the equipment failed during this test, it turned out that the vendors will make repairs free-of-charge, even if this is not explicitly stated in the contract. For some units, thermal vacuum tests were deleted based on the recommendations and experience of the vendor (e.g. torque rods).

Performance incentives
Such incentives were used once in the project. The contractor used to make production drawings for the structure, manage all workshops and assemble the structure was given an incentive of 15000 SEK/kg of reduced mass. At that point the satellite was overweight by 5 kg. The contractor shaved off 15 kg(!) from the specified structure mass. Of course SSC had to make all the analyses to prove that the structure was strong enough to withstand tests and flight.

Limit flight spares
For several units (especially non-electronic), flight spares were not ordered. It was ensured however that a sufficient number of critical parts was available at the vendor to enable rapid repair if necessary: E.g. wire booms, stiff booms, mechanisms, S-band antennas. This arrangement has saved money.

Engineering methods

To keep costs low engineering work has been streamlined whenever possible. Some examples of such methods  are given below.

Avoid "analysis over-kill"
For example, all equipment brackets were not analyzed, only those which were found to be subjected to significant forces. The remaining brackets were qualified during the qualification vibration test. The gains in this case were off-set by the fact that it was found after the vibration tests together with the main satellite that the vibration levels specified by the launcher agency were too low, thus requiring additional analysis at a fairly late stage.

Sometimes it is less costly to make a design change than to continue a costly analysis of an existing design. This was the case when a problem was identified which required knowledge of the temperature of a solid rocket motor casing after firing. A preliminary analysis costing several tens of thousands of SEK performed by the motor manufacturer gave a predicted temperature in the range of 230-480°C. The critical temperature which the motor structure temperature could not exceed was approxi­mately 290°C. A detailed, but expensive, analysis was offered. Rather than performing this, the problem was "removed" by attaching a temperature resistant spacer between the motor and the motor mount. The design change was much less costly than the continued analysis which would probably have led to the design change anyhow!

Contract "one-shot analyses" to external experts
Structural and thermal analyses are tasks that extend for a large fraction of the project duration and are tightly bound to the system design. Therefore the project team shall be able to do these within itself. However, specialized, "one-shot" analysis tasks should be given to external experts. For example, a modal analysis of the wire boom dynamics was performed by Mr. E. Crellin of ESTEC, and a transient dynamic analysis (for the wire boom deployment operations) was' performed- by an outside contractor (Chalmers technical University, Sweden).

Remove tests and rely on analysis
The nutation damper design (tube and endpots) was based on theory found in a Fokker study which was part of an ESTEC contract. The calculated performance was checked with tested performance of similar dampers.used on-the Ge rman AMPTE satellite, and found to be acceptable. Actual testing of the FREJA dampers was therefore deleted, resulting in cost savings of approximately  USD 30,000.

Qualify during system vibration tests
It was the experience during the Tele-X communications satellite project that many large appendages such as antenna reflectors and solar panels were overtested during equipment vibration tests due to non­-representative  mechanical interfaces. The equipment level vibration test requirement for the Freja solar panels was deleted and the qualification of the panels was instead performed during the system acceptance vibration test. The intention initially was to have at least one flight panel ready for the system qualification vibration test, but the panel  was not  ready in time.

Avoid multiple specification margins
Typical equipment vibration qualification levels for FREJA equipment were set at  15 g's between 10-100 Hz. For FREJA, significant notches (down to 2 g's) were granted to certain experiment units in their equipment vibration specifications. These notches were based on the preliminary coupled analysis results and the results of the structural qualification vibration tests.

As FREJA subsystems were not contracted out, no extra margins were imposed as is often the case. With such extra margins at each contractual level the result is higher and higher equipment vibration specs that eventually could leading to overtest and costly failures of the specimen.

EGSE/Control Center Commonality
In the VIKING and Tele-X projects consider­able costs were caused by the fact that the EGSE (Electrical Ground Support Equipment) computers and software were developed by a completely different organization than the one that developed hardware and software for the Satelite Control Center. The EGSE and the Control Center have some basic functions in common, i e. displaying telemetry and issuing commands. In addition there is an immense problem of configuration management of telemetry calibration functions between the EGSE and  the  Control Center.

For  FREJA  the software for  the  EGSE and the Control Center at ESRANGE are identical and are produced by one and the same person. Both the EGSE and the Control Center used "IBM-compatible" PC:s equipped with 80386 microprocessors (+math co-processor) operating at 33 MHz. The only difference between the hardware is that the Control Center has a LAN with a file server, while the EGSE has two stand-alone PC:s (one for TM display and one for telecommanding).

Use powerful and easily available analysis tools
The following powerful analysis tools have been invaluable for the project:

  • A good Finite-Element-Modelling code (ABAQUS)
  • A good thermal analyzer (SSPTA)
  • ESABASE (equipment placement, gravity gradient·analysis, radiation)

These tools are directly available to the project team and analyses are run within hours of finding problems. No work-orders or con tract negotiations were required. The work was just made when needed!

Use ESA expertise
Being a member state in ESA, the availability of help and advice from the staff of ESTEC is invaluable. Help from ESTEC in the following areas were greatly appreciated:

  • ESABASE  "hot-line" support
  • Material selection (J. Dauphin, M. Judd, B. Dunn et al)
  • EEE-parts selection
  • Mathematical Studies Sect. (E.Crellin et al)

Model Philosophy and System tests

Equipment  level models
On equipment level, "off-the-shelf" equipment required only acceptance  testing (or delta-qual if FREJA qual levels exceeded previous qual levels), while new equipment required an engineering model, a qualification  model/flight spare and a flight unit.

The protoflight satellite
For FREJA one complete satellite model was built, the "protoflight" model, which was subjected to qualification  tests and used for actual flight.  Qualification  of  the structure as well as system level acceptance vibration tests were performed in  China, while space simulation tests were performed at IABG, München. The flight structure with equipment mass dummies mounted was used for thermal blanket  manufacturing  and fitting.

The "bench test model"
However, a "bench test model" (BTM) of the satellite was built up in SSC's lab in Solna early in the program. This consists of the breadboard model of the System Unit, a copy of the flight harness, commercial grade batteries, simulators for solar panels and wire booms, engineering model or breadboard experiments, engineering models of new equipment (attitude sensors), flight spares for receivers and tramsmitters, flight units for antennas, pyro simulators.

The BTM was used to verify System Unit hardware and software design. It is also used for "hunting" EMI, testing onboard and ground software. The breadboard System Unit hardware and software configuration was updated to be similar to the  flight unit.

The BTM was in use daily throughout satellite integration and environmental tests for troubleshooting. The BTM is a cost-saving tool. Time­ consuming trouble-shooting tests need not be performed on the flight satellite, but can be performed unhurriedly in parallel with satellite testing. The video clip below gives an impression of the BTM.



The wooden mockup
Harness routing was performed on a high­ fidelity wooden mock-up using the same equipment mass dummies that were later used for the system qualification vibration test. The picture below was taken at FFV Aerotech in Arboga. AIT manager Stig Alterbäck poses next to the wooden mock-up.

The radio-frequency test model
A full scale sheet-metal model of the satellite with a prototype TC antenna and the Ulysses flight spare TM antenna (on loan from ESA­) was used early in the project for antenna range measurements aimed at finding the optimum location of TM and TC antennas. This model was updated and used with FREJA flight antennas to make a final verification of antenna  radiation patterns. The Rf test model under test at FFV in Arboga is shown below.

System Level Tests
Except for the use of the protoflight model philosophy on system level no normal spacecraft system tests have been deleted from the FREJA development program. In addition to the antenna range measurements made on the RF test model, the following tests  have been performed on the  protoflight satellite:

  • Static load test
  • Structural qualification vibration test
  • EMC system level test (REE only)
  • Acoustic noise test
  • Mass properties test
  • Deployment test
  • Acceptance vibration test
  • Solar simulation vacuum test
  • Magnetic survey
  • Ground station compatibility test

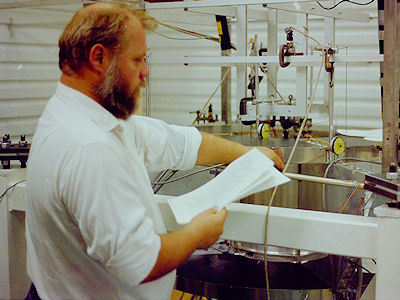

Static load test at Lars Stenmark's ACR.


Vibration test on system level


Acoustic noise test


Solar simulation test


Magnetic survey


Ground station compatibility test

ORGANIZATION

Customer Relations
A cost-saving feature in the FREJA project has been the very flexilble attitude of the Customer (the Swedish National Space Agency, SNSA) regarding reporting. Because of the co-location of SSC and its Customer, oral reports are given directly to the President of the Board on a day­ to-day basis. Formal, brief written reports were been submitted at roughly two month intervals in connection with meetings of the Science Committee  and board  of  directors  of  the SNSA. The SSC project manager also issued a "Project Newsletter" at three-month intervals giving news about progress and problems.

The technical interface with the Customer was the Project Scientists. SSC discussed directly with Professors Lundin and Haerendel about satellite performance and technical risks. Such matters were also freely addressed at the Science Team meetings held every six months. At such meetings scientists and engineers from PI:s and Col:s participated without limitation. Design reviews were been attended by SNSA administrators and scientists and engineers from the experimenters.

Of course, SSC's project team realized that this attitude of the Customer was a result of their trust in us, something we appreciated very much and constantly worried about being worthy of.

The small project team - the "sink- or-swim" approach
When starting FREJA it was evident that the only chance to meet budget constraints was to use a very small, multi-skilled project team throughout the design, development and test phase. A table below shows how SSC's project team members covered many aspects of developing the satellite.


Sven Grahn


Caroline Birger


Peter Rathsman


Anna Laurin


Bengt Holmqvist


Gudmund Johansson


Lennart Pettersson


Göran Bergman


Hans Ringstrand

One  of  several  inspiration  sources  in organizing the  FREJA team  has been  the "Skunk Works" organization  at  Lockheed set up  by "Kelly" Johnson  to  develop such airplanes as the U-2 and SR-71 "Blackbird". In his memoirs [1] Johnson  listed fourteen  points to observe when running a "Skunk Works" organization. The following points are of particular  inter est:

  1. The Skunk  Works manager must be delegated practically complete control of his program in all aspects. He should report to a division president or higher. .....
  2. ...
  3. The number of people having any connection with the project must be restricted in an almost vicious manner. Use a small number of good people (10 percent to 25 percent compared to the so-called normal systems).
  4. A very simple drawing and drawing release system with great flexibility for making changes must be  provided.
  5. There  must  be  a  minimum  number  of reports required, but important work must be recorded  thoroughly.

In organizing the FREJA project team we tried to follow these recommendations. The same small group has worked on the project more or less full-time. Very little part-time manpower has been used. In this way the risk of a part­ time worker using more time than allocated in the budget is avoided. However, this philo­sophy requires that the project  team can handle all technical, management and clerical matters (team members typed their own memos and typed and sent letters and faxes - this was in the pre-Internet era). In FREJA, this is what the team was forced to to do; It was a philosophy of "sink or swim"!

Since almost every team member in addition to technical tasks had a subcontractor management task he/she identified with the project, became an active participant in the daily management of the project and was acutely aware of the schedule constraints imposed on the work. So, each team member was important and not immediately replaceable. This presented a risk to the project in case a team member left the company, became ill or is otherwise incapacitated - soemthing that did not happen.

However, these risk are greatly outweighed by the many,advantages in having.a small project team. Below follows a description of some of the more obvious.

Minimizes  costly interface work
A small team minimizes interface work. For example, a two-person team at SSC were responsible  for  structure  design and analysis, location of units & mass balancing, thermal design and harness routing. Such a small group means that a large number of interface drawings could be deleted.

A basis for quality
A small team also means that everyone can participate in project meetings and get an overview of all activities in the project and how their own work is related to the overall progress of the project. Actually, the project meetings were not only used for reviewing progress and "nagging about action items" but also for discussing and deciding on design, test and other technical problems. With everyone participating in the discussion, every system aspect is represented, and high­ quality technical decisions can be taken quickly with very little paperwork. The team has an overview of the system and the "conceptual integrity" of the system is maintained in everyone's mind. This is how quality is "built-in"!

By having the same persons be involved in design,  manufacturing  and  test  matters such as parts,  materials  and  processes  selection will not be forgotten. Of course, the use of recognized standards and guidelines is essential, but the enforcement of  such guidelines requires no extra effort, since each worker is responsible for the performance of his/hers part of the final product as measured in system testing.

Reduces cost by absorbing risk
As can be seen from the table above describing the tasks of SSC's project team it has been responsible not  only for design tasks but also for the system test specifications, predictions and test evaluation reports. This meant that test requirements were taken into account already in the design stage of  the  system hardware. This also meant that the AIT contractor was mainly contracted to do "hands-on" work, with the actual responsibility for test methods and test setup always remained with SSC, thus saving money (buying "risk absorption" is costly!).

The organization table covers the full-time members of SSC's satellite design team. In addition, support from the department's secretary has been obtained for document copying and filing. Analysis of the ground tracking strategy and adaptation of orbit determination software was performed by a part-time engineer.

Also, about 18 months before projected launch a three-man team began preparing for satellite operations, by writing a satellite manual and Flight Operations Procedures.

SATELLITE OPERATION AND DATA ACQUISITION

Data Acquisition
An important parameter in deciding when to operate the experiments on FREJA and when to transmit data from the satellite was the determination of periods when the satellite passed through the auroral oval in the northern hemisphere.

An overview of the passes of the satellite through the auroral oval is shown below. The red parts of the track (the field line footpoint) represents passes through the oval. The circles along the  track indicate the position of the satellite every 5 minutes. (The blue lines show the radio horizons around Esrange and Prince Albert - green spots). From this figure it is evident that on a typical northern hemisphere pass the fieldline footpoint goes through the oval during two periods, each being 2-4 minutes long.

Eight out of thirteen orbits per day go through the oval. This figure clearly shows the need for a ground station Canada in order to cover as many passes through the oval as possible. Therefore, a receive-only station at Prince Albert in Saskatchewan (53.21°N, 105.93°W) was used. Of the 8 orbits per day that went through the oval Prince Albert could receive data during 7 and ESRANGE during 5 orbits. However, Prince Albert covered "better" passes through the oval than ESRANGE.

Commands for transmitting data and for switching on and off experiments were all transmitted from ESRANGE. The satellite had a stored-command capability.

A total of 140 minutes (270 MB) of data could be received at the two ground stations per day if the downlink data rate was 262 kbps. The radio link was able to support 524 kbps during passes over ground stations.


The Esrange ground station
The TT&C (Telemetry, Tracking & Command) station was responsible for RF (Radio Frequency) communications between FREJA and the ground segment at ESRANGE. The TT&C station antennas tracked the satellite and provide transparent throughput of telemetry data and commands between FREJA and the operations center.

For reception S-band  there were at least three antennas available, the largest of which had a diameter of 13 meters. Data rates up to 524 kbps were therefore possible. All receive antennas had auto-track capability.

The uplink antenna at ESRANGE was the 7 meter UHF antenna used for transmitting commands to sounding rockets and balloons and for receiving satellite telemetry. The output power at 449.95 MHz, the FREJA command frequency, was up to 400 Watts. The antenna could be program-steered or slaved to any receive antenna.

The FREJA Operations  Center (FOC)
The operations center for the FREJA mission provided all services necessary for the control and monitoring of the satellite. Its primary function was to control and optimize satellite performance and to store and protect the integrity of the downlinked telemetry data. Thus, its functions were:

FOC was located within the TELE-X Satellite Control Facility (used for real-time control of the TELE-X geostationary communications satellite). FOC staff communicated with the science center by intercom and between FREJA passes the satellite operator conferred with the scientists face-to-face. The picture below shows satellite operator Anders Nilsson on-console in the Freja Operations Center.

The FREJA Interactive Science Center (FISC)
The science center was the interaction point between the scientists using FREJA and the Operations Center. The most important functions of FISC were to reduce telemetry data in near real time or to process stored burst memory data, to display this data in a convenient form for the on-site scientists and to allow rapid interaction between the scientists and the experiments on board FREJA

FISC consisted of computers and other facilities provided by the scientists. SSC made available an interface to the Operations Center computers through which the scientists had direct command access to their experiments during passes over ESRANGE. FOC was transparent to such commands and only filtered the science command stream to make sure that no satellite-level commands were transmitted. FISC was located in the lobby of the TELE-X Satellite Control Facility. This lobby was divided into sections for each PI.

The Prince Albert Satellite Station
The primary function of the Prince Albert ground station was to receive data from FREJA as directed by the FREJA Operations Center and to store and protect the integrity of the downlinked telemetry data and forward it to ESRANGE by parcel mail. The largest antenna available at Prince Albert has a diameter of 26 meters and a beamwidth of 0.36°. This antenna easily supported a 524 kbps data rate.



Data Categories
During a pass over a ground station the station collected data on hard disks


DAT tapes from Freja still kept in 2015 at the Space and Plasma Physics
Group at the Royal Institue of Technology in Stockholm (KTH).

The F1 experiment on Freja was developed by the Space and Plasma
Physics Group at KTH. Göran Olsson worked on its design.

LAUNCH AND EARLY OPERATIONS

FREJA was launched (this video clip was compiled by Gudmund Johansson, a member of the Freja project team) at 0620:05 UT on October 6, 1992 (see picture below). FREJA was given the international designator 1992-64 A and the US Space Command catalog number 22161. The mass at launch was 255.85 kg and the on-orbit mass 214.0 kg. The initial orbit ranged between 601.0 km and 1756 km at 63.0° inclination. The initial nodal period was 108.97 minutes and the initial argument of perigee was 260°. The satellite is expected to decay from orbit due to atmospheric drag in >250 years.


Freja was launched at 0620 UT on 6 October 1992.




Traditional group picture taken after the launch of Freja. Swedes, foreign partners and key Chinese staff.

Orbit maneuvers
The Chinese CZ-2C launch vehicle put FREJA into an initial 213.7-317.4 km orbit at 63° inclination. This orbit was too low for a long duration mission and much too low for any meaningful science investigations. Therefore FREJA is equipped with two solid propellant rocket motors that were used to raise both the apogee and the perigee. Before firing the motors the satellite was also spun up to 50 rpm by small solid propellant rockets. The firing of these rocket motors and other critical operations during the first orbits were controlled by the on board computer. The actual time line for the initial operational phase through the first ground station contact was as follows:

Event

Time, UT

Lift-off

06:20.05

Freja separation (115.3°E, 18.44°N)

06:30.01

Spin up

06:30.11

STAR 13A

06:56.59

STAR 6B

07:49.47

Spin down

07:51.47

400MHz transmitter ON

07:52.33

400 MHz TX OFF

08:15.33

Initial attitude maneuvers
The first boom systems to be deployed in orbit were the stiff booms carrying the magnetometer and the wave antenna. The hinges of the boom were not  illuminated by the sun when the satellite entered orbit. In order to ensure a smooth deployment of the booms the satellite was turned by magnetic torquers so that the sun would warm the hinges. This meant that the angle between the spin vector and the solar direction (which was measured to be 38.7° just after injection) was increased to 59.8°. This maneuver took place between orbit 55 (October 10) and orbit 81 (October 12). The U.S. F2 magnetometer was used for attitude determination during this maneuver, even though the magnetometer was not deployed. Before this precession of the spin vector took place, the spin rate was increased from 6.8 rpm to 8.2 rpm  by means of a magnetic torquer. Prior to deployment of the stiff boms the spin rate was further increased  from 8.2 rpm to 12.8 rpm.

Boom  deployment operations
The outer and inner sections of the stiff booms for the magnetometers were deployed by stored commands over the Southern hemisphere on October 13 at 0210 UT and 0400 UT. Other science sensors were deployed on October 14 and the Stacer boom for the Canadian Cold Plasma Analyzer came out on October 15.

Deployment of the three wire booms pairs to 10 m, 10 m and 5 m respectively was comple ted late on 22 October. Two pairs were deploy­ed to 10 meters length per boom (i.e. 20 m tip­ to-tip) and one pair was reeled out to 5 meters (10 m tip-to-tip).

Changes in  spin and attitude
The satellite was then spun down to 10.03 rpm and maneuvered so that the spin axis got close to the sun. On November 17, the spin rate was measured to be 9.97 rpm indicating a slow decrease of the spin rate, probably caused by eddy currents induced in the structure or some other damping mechanism. If needed regular spin-up maneuvers can be performed to main­ tain  the spin rate very close to 10 rpm.

Since the radius vector to the earth's center does not normally lie in the plane of the wire booms there is a gravity-gradient torque acting on the spacecraft caused by the long booms.
This torque causes a motion of the spin vector. Between November 17 and November 18 the declination of the spin vector changed +0.5°/­ day and the right ascension -1.7°/day. The figure below shows the motion of the spin axis relative to the sun during the first year of operations.

Science data collection
Science data taking operations started at full scale in late October 1992. Data reception at the Prince Albert Satellite Station in Saskatche­wan, Canada, began on October 24. The two ground stations received and distibuted about 400 MB of data per day. Data were distributed as DAT tapes to PI:s and Col:s. So-called FREJA Summary Plots were generated at Es­range and distributed via computer links in PostScript format.  The image below shows the aurura as seen by the Canadian F5 imager on Freja on 9 December 1992. The track of the magnetic field-line footprint through the auroral arc is marked.

The Freja mission ends

A fter four successful years of operation (four times the intended lifetime) Freja ceased to respond to commands. This was discovered on Wednesday October 9, 1996. Pre-programmed commands switched on the transmitter for the last time at about 2030 UT on Monday, October 14, 1996. The cause of the loss of the command link was probably caused by radiation damage to a monostable multivibrator in both command bit synchronizers.

Freja has been operated from SSC's space operations base at Esrange, Kiruna. The primary mission ended June 30, 1995. Up until that date, all possible orbits were received from Esrange and the Canadian station at Prince Albert, Saskatchewan. Starting on July 1, 1995 only one pass over Esrange per weekday was received.

A large number of scientific papers about the results of the Freja mission have been written and a book with a collection of such appears, "The Freja Mission" has been published by the Kluwer publishing house.

The end of Freja

The graph below has been computed using NASA's Debris Assessment Software. It shows that Freja till stay in orbit a few hundred years.

REFERENCES

  1. Clarence L "Kelly" Johnson, "KELLY, More Than My Share of It All", Smith­sonian Institution Press, Washington D.C. ,1985, pp 170-171.


Back to Space History Notes

Back to Swedish Space History
